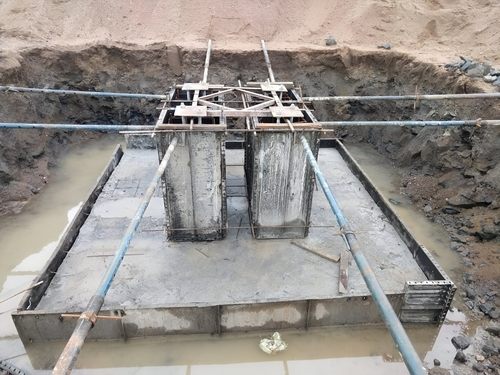

The timing of deshuttering is critical to the strength and durability of concrete structures like slabs, beams, and columns. Premature removal can lead to cracks, deformation, and even structural failure, compromising safety.
Ambient temperature, concrete grade, and cement type all play significant roles in determining deshuttering time. Warmer temperatures and higher-grade concrete can speed up curing, reducing the time needed before formwork removal.
The deshuttering time for columns differs for columns, beams, slabs, and footings. Columns may be deshuttered in 24 to 48 hours, while beams and slabs require 7 to 14 days. Understanding these timeframes ensures proper strength development for each structure.
Deshuttering refers to removing the temporary formwork used to shape and support freshly poured concrete until it gains sufficient strength. Formwork, also known as shuttering, holds the concrete in place while it sets and hardens. The timing of deshuttering is critical because removing the formwork too early can weaken the structure, leading to cracks, deformations, or even structural failure.
Concrete gains strength gradually over time. The rate of strength development depends on factors like the type of cement, curing conditions, and environmental temperature. If the formwork is removed too soon, the concrete may not be able to bear its own weight or additional loads, which can compromise its durability and safety. The deshuttering meaning revolves around ensuring that the concrete achieves its required strength before bearing loads. Proper deshuttering ensures that the structure can support its intended load and withstand environmental conditions.
Slabs: These are flat, horizontal structural elements that form floors and ceilings in buildings.The deshuttering period of slab needs sufficient curing time to prevent sagging or cracks.
Beams: These horizontal supports transfer loads from the slabs to the columns. They require a longer deshuttering period since they bear significant structural loads.
Columns: Vertical structural elements that transfer building loads to the foundation. The column deshuttering time is less than that of slabs and beams, but sufficient curing time is still essential for stability.
Deshuttering time for columns generally refers to the period required before removing the formwork (shuttering) from concrete structures like columns, beams, footings, and slabs. This duration is critical to ensure the concrete gains sufficient strength to support its load without cracking or structural failure.
The standard deshuttering time varies depending on factors such as concrete mix, curing conditions, and the type of structural element. Generally, the guidelines followed in construction projects are:
Deshuttering is usually done after 24 to 48 hours of concrete pouring, as vertical elements gain strength faster due to their smaller surface area.
The deshuttering time for slab and beam formwork typically ranges from 7 to 14 days, depending on the span and load-bearing requirements. Larger spans may require longer curing times to ensure adequate strength development.
The formwork for footings can typically be removed after 7 days, as they rest on solid ground and experience minimal external stress.
For structures like cantilever beams and slabs, deshuttering should be done only after 14 to 21 days to prevent deflection or structural instability.
Understanding these factors helps in planning the construction process effectively. Several factors can affect the appropriate deshuttering time:
Higher-grade concrete tends to gain strength faster, potentially reducing deshuttering time.
Rapid hardening cement allows earlier formwork removal than ordinary Portland cement.
Also Read: 15 Types of Cement: Uses & Different Grades
Warmer temperatures accelerate concrete curing, while colder conditions slow it down, necessitating longer deshuttering periods.
Larger concrete sections may retain heat longer, affecting the curing and deshuttering schedule.
Removing formwork prematurely can lead to several issues:
The concrete may not have achieved adequate strength, leading to potential failures.

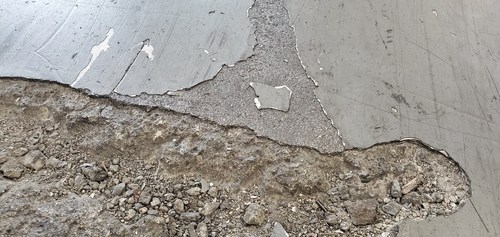

Early removal can cause spalling or cracking on the concrete surface.
Elements like beams and slabs may sag or deflect if not adequately cured.
Proper deshuttering is essential in concrete construction to ensure that each structural element achieves the necessary strength before formwork removal. Since you only build your home once, every step in the process must be done with care—from selecting the right materials to following the correct construction practices. Timely and proper deshuttering ensures long-lasting stability, strength, and safety for your home.
Deshuttering involves the systematic removal of formwork from cured concrete structures. The process starts with vertical elements like columns and walls, followed by horizontal components such as slabs and beams, ensuring that the concrete has gained sufficient strength at each stage.
The soffit formwork for slabs can generally be removed after 3 days, provided that props are refixed immediately to continue supporting the slab until it reaches full strength. The total time before completely removing all support can range from 7 to 14 days, depending on the span of the slab.
The soffit formwork for slabs can generally be removed after 3 days, provided that props are refixed immediately to continue supporting the slab until it reaches full strength. The total time before completely removing all support can range from 7 to 14 days, depending on the span of the slab.
The reuse of shuttering materials depends on their quality and maintenance. Wooden formwork may be reused multiple times if properly cleaned and stored, while metal formwork can have a longer lifespan, enduring numerous uses before replacement is necessary.
